Microtrans is licensed by Government of National Capital
Territory of Delhi to carry out electrical installation, testing, repair and
servicing. We also possess the necessary relevant instrument i.e. Insulation Tester,
Earth Resistance Tester, Volt-Meter, Arm-Meter, multimeter etc for carrying out
electrical work. Traffic Signal Installation is a specialised task which is
undertaken by our expert team who ensure installed traffic control infrastructure is
better usable by motorist, bicycle and pedestrian. Microtrans Installation Team is
highly experience in execution of turnkey project of Traffic Signal Systems across
India.

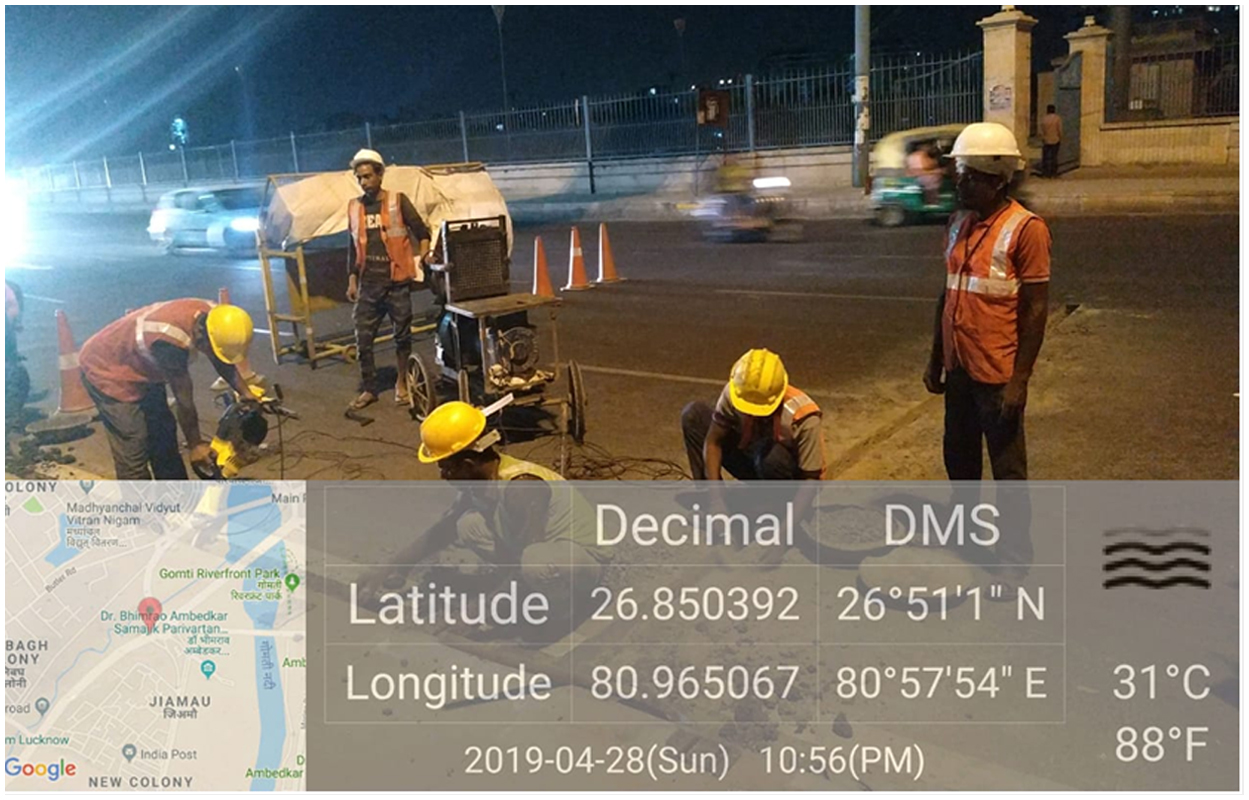

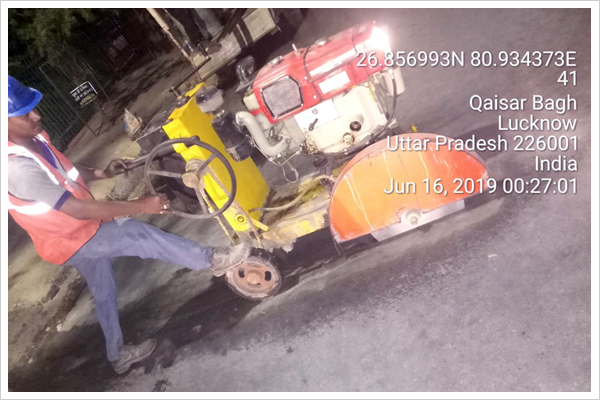

We carry out various electrical and civil activities includes road

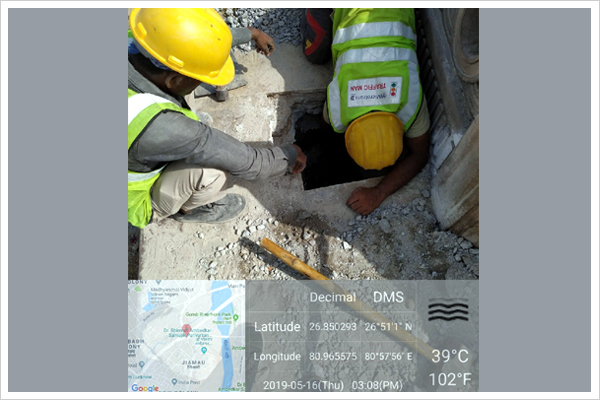

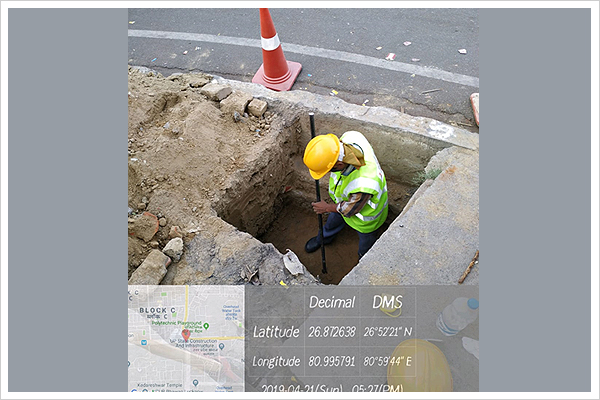

cutting, trenching, ducting, cable laying, installation of Electronic & Electrical

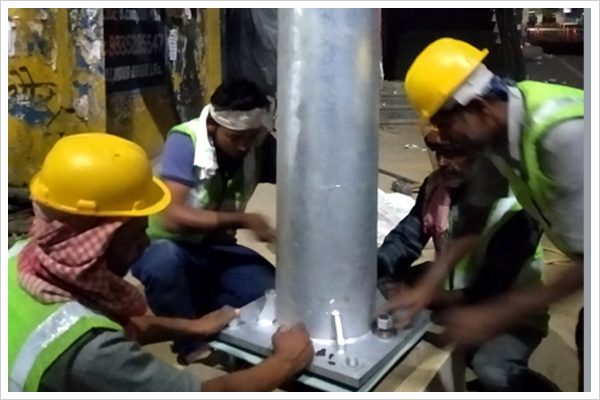

components of the project and civil work such as foundation and installation of

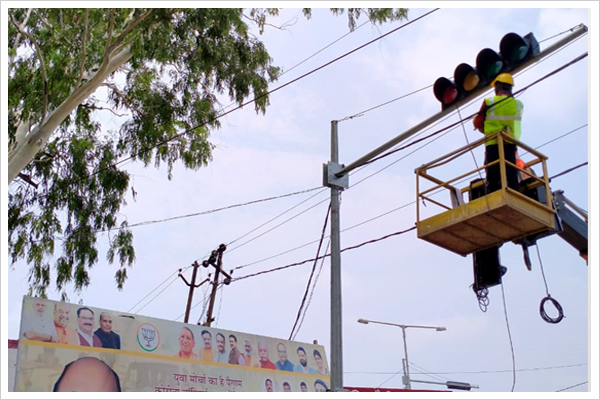

Traffic Poles. Further perform testing and commissioning of complete systems. Our
team address all mobility and safety measures as well as opportunities to enhance
the accessible road spaces. We also follow International and Indian Standard
guidelines (IRC) during installation of Road Traffic Signals. A number of health and
safety procedures are being be taken into account during the installation of traffic
signals as there are a number of significant hazards such as working alongside live
traffic, working at height and working with live electricity .

On existing traffic intersection installation, we usually arrange a form of temporary traffic management and in busy situations, we organize installation work in off peak hours early morning and late night or Saturday & Sunday to minimise traffic congestion, although this does vary depending on the location of the installation.
Pre- Installation Test
Each piece of
equipment, component, element and appurtenance, of the Traffic Control system is
individually tested by our Project Engineer under the supervision and to the
satisfaction of the Project Manager / Client’s Engineer before installation. Pre –
installation tests shall emphasize proper operation and functioning of each unit of
equipment, component, element and appurtenance, whether manufactured and or
assembled by the Contractor himself or supplied by a sub-Contractor or a
manufacturer other than the Contractor.
No pre – installation test shall be
considered complete unless the unit being tested meets, in the judgment of the
Engineer, all the material, operating and performs criteria established in the
Contract Documents.
Any unit that fails to pass any pre – installation test
shall be so marked by the Project Engineer and shall be replaced by the Supplier
until the replacement passes all pre – installation tests to the satisfaction of the
Project Engineer / Client’s Engineer.
No unit shall be installed in the field unless the Engineer issues a
pre – Installation Test Certificate indicating that the unit has passed required tests
to his satisfaction.
The Engineer shall have the option of waving pre –
installation testing requirements for a group of like units, after testing a sufficient
number of units, randomly selected by him, from such group of like units.
Post – Installation Test
Following the
installation of equipment, components, elements and appurtenances of the Traffic Control
System, we perform post-installation test under the supervision of Project Manager and
to the satisfaction of the Client’s Engineer. Post installation test shall emphasize the
functional operation and performance of a systems as well as the performance of its
components.
Post installation test shall be considered complete unless the system
and its components being tested meet, in the judgment criteria established in the
Contract Documents.
Any system or its components that fail to the pass any
post-installation test shall be replaced by us or supplier until the replacement passes
all post-installation tests to the satisfaction of Project Manager / Client’s Engineer.
System Start-up and Initial Operation
Following
the issuance of a Post Installation Test Certificate by the Project Manager / Engineer,
we shall start up the systems that passed the post-installation test, and shall
continuously operate the system for an initial operation period of time. The Project
Engineer, Project Manager and Client’s -personnel shall be present at the start-up and
initial operation of all equipment, components and systems.
During the initial
operation period, we shall continuously observe and monitor the operation of the system
and shall make final adjustments and corrections to the systems to the satisfaction of
the Project Manager / Engineer. If during the initial operation period major systems and
/ or component defects are identified which, in the judgment of the Engineer, require
modifications to the system and / or its components, the initial operation period shall
restart the following the completion of the subject modifications to the satisfaction of
the Engineer.
Site Acceptance Test
When the Traffic Control
system started – up and performs to the satisfaction of the Engineer during the initial
operation period of time. We shall handover all wiring diagram, installation manual and
intersection drawings, Consumption report of materials, measurements, all the document
related to operation and maintenance of Traffic Control System to the Project Manager.
Keyword : Traffic Light Product knowledge training, Traffic Signal training, traffic control system training, traffic light training, Traffic Signal Controller training. Traffic light operation and maintenance training
